With the launch of 35MW Geotérmica Platanares SA de CV (“Platanares”)
electric power generation plant Honduras has added geothermal energy to its
renewable energy matrix project portfolio.Privately owned, Platanares is the first utility-scale geothermal
project in Honduras.Although only
recently inaugurated, the interest in developing the potential geothermal
energy generation in Honduras, including the Platanares site, dates back to the
mid-1970s.
Geotérmica Platanares SA de CV 35 MW power plant in Honduras
Early Geothermal Energy Studies in Honduras
The first study for potential development of geothermal
energy in Honduras was carried out in 1976 by the United Nations and identified
several areas of interest including the Platanares area, located in the
municipality of La Union, department of Copán, in western Honduras.Leveraging on this geothermal reconnaissance
work, a subsequent assessment of the nationwide geothermal resource potential
of Honduras was conducted as part of the Central American Energy Resources
Project sponsored by the U.S. Agency for International Development (“USAID”).As part of this assessment project, the Los
Alamos National Laboratory (“LANL”) in May 1986 issued a field report on the Geology
of the Platanares Geothermal Site which included measurements taken at various surface
hot springs.The investigation, a joint effort
by the LANL and U.S. Geological Survey (“USGS”) of the United States of America
and the Empresa National de Energia Electrica (“ENEE”) of Honduras held that a preliminary
evaluation showed upstream from the observed hot springs, the Quebrada del Agua
Caliente flowed with a temperature of 21°C (69.8°F) at several thousand liters
per minute during the field work yet downstream temperatures averaged
approximately 37°C (98.6°F), which indicated an increase of the stream's
thermal energy on the order of several megawatts. Because this estimate was larger than the
integrated value of the measured hot springs the report stated that there must
be a significant contribution from unmeasured springs that were submerged in
the stream bed.
Map of hot springs in the Quebrada del Agua Caliente near Platanares (Source: Los Alamos National Laboratory “Geology of the Platanares Geothermal Site” field report, May 1986)
This preliminary investigation recommended the drilling of thermal gradient boreholes drilled to several hundred meters below Platanares (on the terrace) to provide information needed to make decisions on the potential use of this geothermal resource for electric power generation. Subsequently, as part of a deeper study, three wells were completed to depths ranging from 428m (1404.2 ft) to 679m (2227.7 ft). With the geological and geochemical results obtained the LANL/USGS team concluded the work at the site by 1991 with a report to ENEE recommending geothermal assessment feasibility levels in this Platanares area.
In addition to Platanares, the LANL/USGS/ENEE geothermal research was conducted at five additional sites (San Ignacio, Azacualpa, Pavana, Sambo Creek and El Olivar) showing an estimated combined potential of 120 MW of geothermal electricity generation in Honduras.
Potential for geothermal electricity generation in Honduras (Source: Honduran Ministry of Energy, Natural Resources, Environment and Mining General Directorate for Energy.)
In spite of the promising results of the 1985-1991 USAID-sponsored studies indicating the likely existence
of medium to high enthalpy geothermal resources, no further exploration was
carried out until 18 years later when, in 2009, geothermal exploratory workwas resumed by Electricidad de Cortes, S.R.L. (“ELCOSA”),
a private Honduras company, through its affiliate Geotermica Platanares, S.A.
de C.V.
Stimulation of Renewal Energy Projects to meet Power
Generation Needs
Honduras requires a 26% increase in power generation
capacity over the next decade to keep up with projected GDP growth.
To meet this demand from domestic renewable resources, the government
of Honduras has an established goal of generating 80% of its energy from
renewables by 2032 and in 2007 enacted the Law for the Promotion of the
Generation of Electric Power by Renewable Resources (May
31, 2007 Legislative Decree No.70-2007 published in the Official
Publication La Gaceta
on October 2, 2007) providing a tax exemption during the first 10
years of the renewable energy plant’s operation as a way to stimulate projects to
meet the renewable resources energy contribution target.
The country has steadily been increasing its installed
capacity in renewable energy and diversifying the energy mix with new power
generation technologies such as solar and wind, while simultaneously increasing
hydroelectric and biomass generation. As
of 2017, 62% of the installed power generation capacity of Honduras depended on
renewable resources and only 38% on fossil energy.
2017 Energy Matrix of Honduras Installed Electric Power Generation Capacity (Source: Boletín de Datos Estadísticos – diciembre 2017, Gerencia de Planificación, Cambio e Innovación Empresarial, ENEE)
Prior to Sept. 1, 2017 (commencement of Platanares generation),
despite providing an exceptionally constant source of energy and a top ranked
availability factor, geothermal energy had been noticeably absent from the
energy mix as any potential geothermal energy generation had been held up in the Honduran National Congress (the governing body that
must ultimately authorize all government contracts) since January 2009 when the
first geothermal energy project contract was granted
to Geotérmica Platanares, S.A. de C.V. by the Honduran Secretariat of Natural
Resources and Environment (“SERNA”) (January 6, 2009 “Contrato de Operación”). Although the PPA contract with the ENEE (June
3, 2010 “Contrato de Suministro de Potencia y su Energía Asociada No. 086-2010)
was approved (Legislative Decree 159-2010 published in the Official
Publication La Gaceta on December 31, 2010), the permission to operate
languished in the National Congress. Recognizing
the potential of geothermal energy projects to generate sustainable, reliable,
and cost-effective power, while contributing to the country’s goal for increased
installed renewable energy capacity and diversification of the energy matrix, on
March 14, 2012 (Legislative Decree 197-2012 published in the Official
Publication La Gaceta on January 31, 2013), after 3 years of paralysis, the
Honduran National Congress began giving the final approval to geothermal energy
project contracts with 95MW of the 120MW of the country’s combined geothermal
energy general potential now already authorized.
Authorized Geothermal Power Generation Projects in Honduras
Geotérmica Platanares Economics and Financial Structure
The Platanares project has secured a 30-year Power Purchase
Agreement for up to 35 MW with the national utility of Honduras, ENEE. The average annual production is 297,400,000
kWh per year with the expected value per kWh hovering around $0.112/ kWh, which
provides a lower purchase cost to the ENEE per kWh than the energy generated
from other renewable resources. The
project is expected to generate average annual revenue of approximately $33
million and benefits from the tax exemption during the first 10 years of
operation.
While ELCOSA and its affiliates, as a privately-owned
independent power producer in Honduras having an expansive portfolio that
includes large utility scale solar, hydro, and HFO-thermal electric generation,
had engaged in geothermal exploratory work at Platanares since 2009, the
company decided to partner with Reno, Nevada-based Ormat Technologies, Inc.
(NYSE: ORA) (“Ormat”) for development of the geothermal power plant. Having built more than 2,100 MWs of
geothermal capacity in more than 150 geothermal power plants across more than
25 countries worldwide, Ormat was selected for its leadership in the global
geothermal sector. Leveraging Ormat’s vast
expertise, the Platanares geothermal plant has been designed to harness the
power and lifespan of the areas reservoirs by re-injecting 100% of all
geothermal fluids, and hence the geothermal solution is sustainable and
virtually emissions-free while the facility has been environmentally designed
to blend into its natural surroundings of the Copan mountains.

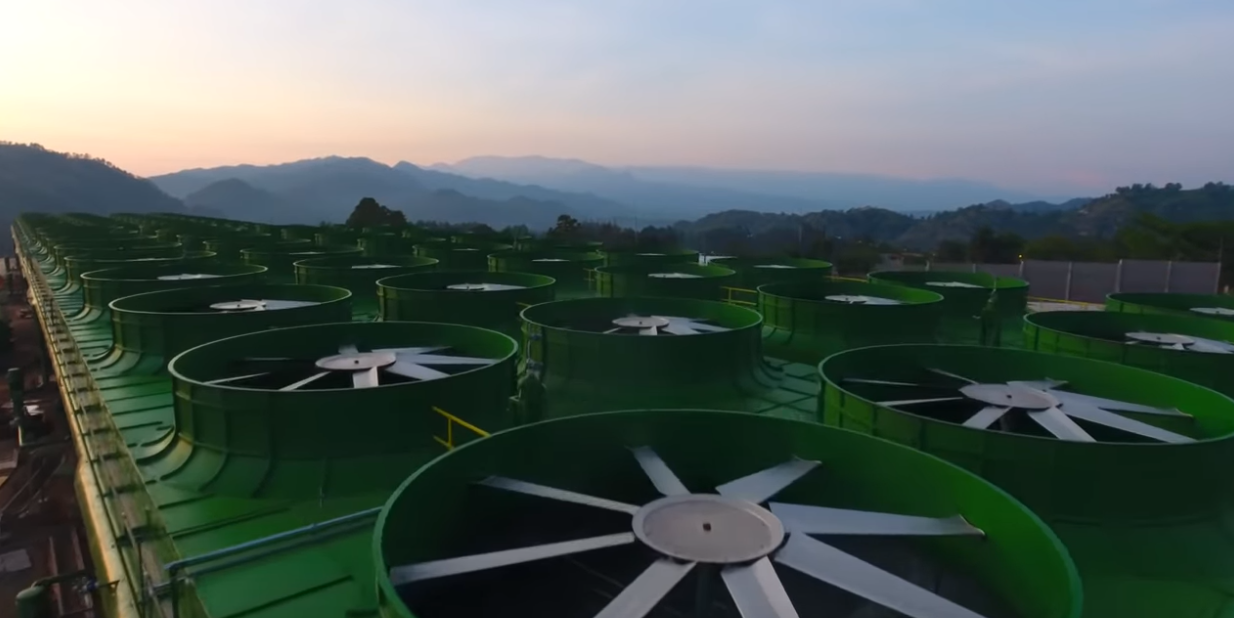

35MW Geotérmica Platanares power plant located at La Unión, Santa Rosa de Copan, Honduras
In November 2012, ELCOSA and Ormat entered into a Build,
Operate, and Transfer (“BOT”) contract for the Geotérmica
Platanares geothermal project under which Ormat became the owner of all
project assets, including wells, land, the Power Purchase Agreement and
necessary permits to develop the geothermal project. Ormat will hold the assets under the BOT
structure for approximately 15 years commencing from the commercial operation
date (“COD”), after which the project will revert in full to ELCOSA.
The roughly $180 million geothermal project is funded by private
Honduran and foreign investment. With approximately $45 million having already
been contributed in cash and/or assets satisfactory as equity or subordinated
debt the project is supported by $124.7 million of financing from the Overseas
Private Investment Corporation (“OPIC”), the U.S. Government’s development
finance institution, as the sole lender.
On May 03, 2018 Ormat completed the closing of the finance agreement and
received a disbursement of $114.7 million representing the full amount of
Tranche I of the OPIC non-recourse project loan that carries a fixed interest
rate of 7.02% per annum with a maturity of approximately 14 years. The closing
of the second tranche of up to $10 million is expected during the first half of
2019.
35MW Geotérmica Platanares power plant located at La Unión, Santa Rosa de Copan, Honduras
Inauguration
Although commissioned by Ormat on September 1, 2017 as the
official COD, the 35 MW Platanares geothermal power plant was officially
inaugurated seven months later on April 30, 2018. At the ribbon cutting ceremony, Honduran
President Juan Orlando Hernández, CEO of Ormat Technologies Isaac Angel, and U.S.
Overseas Private Investment Corporation (OPIC) Vice President for Investment
Policy Ryan Brennan inaugurated Geotérmica Platanares. In attendance at the inaugural event were
also Larach family members of ELCOSA, local dignitaries, business and community
leaders, as well as additional Honduran and U.S. government officials, and
other Ormat senior leadership.
Geotérmica Platanares Inauguration
Performance Statistics and Ormat geothermal technology
In December 2015, Ormat concluded the drilling activity as
well as extensive tests that supported the decision to construct the 35 MW project. The project has two (2) exploration
wells, one (1) monitoring well, four (4) production wells, and two (2) injection
wells.
35MW Geotérmica Platanares power plant located at La Unión, Santa Rosa de Copan, Honduras
35MW Geotérmica Platanares power plant located at La Unión, Santa Rosa de Copan, Honduras
From COD on September 1, 2017 through October 13, 2017, Ormat
reported field-wide performance was steady, with net generation at the expected
output of 35 MW. The four production wells were steady in these first 6 weeks of
commercial operation:
Geotérmica Platanares start-up period performance
The total of these rates is 10,895 gpm. During the initial start‐up period,
individual wells showed production rates as high as 4,000 gpm, and the sum of
the individual maximum rates would be over 14,000 gpm. This suggests that there
is a surplus of approximately 30% in the combined capacity of the production
wells. The operational data reported by Ormat suggests that resource decline is
minimal and the production well capacity is more than sufficient for 35 MW of
net electrical generation.
The Platanares geothermal plant uses Ormat’s binary
technology. According to Ormat, binary
plants are ideal for geothermal reservoirs to maximize sustainability and
return on investment. Binary plants maximize sustainability by reinjecting 100%
of the geothermal fluid, maintaining reservoir pressures. Return on Investment
(“ROI”) is maximized due to much lower operating costs and higher resilience to
changing reservoir conditions thereby maintaining higher efficiency over the
long term.
Ormat Technologies Geothermal Combined Cycle Power Plant
As shown in the image above in Ormat’s geothermal combined
cycle power plant the hot geothermal fluid is extracted from an underground
reservoir and flows from the production wellhead through pipelines to heat
exchangers in the Ormat Energy Converter (OEC).
Inside the heat exchangers, the geothermal fluid heats and vaporizes a
secondary working fluid which is organic, with a low boiling point. The organic vapors drive the turbine and then
are condensed in a condenser, which is cooled by either air or water. The turbine rotates the generator. The
condensed fluid is recycled back into the heat exchangers by a pump, completing
the cycle in a closed system. The cooled
geothermal fluid is re-injected into the reservoir.
To learn more about how Ormat’s geothermal power generation binary
technology process implemented at Geotérmica Platanares in Honduras works Ormat
has produced this excellent introductory video
